Mobile Modular Ammonia Demonstration Unit – FEL 2A (Select Phase)
GATE Energy was engaged to execute FEL 2A (Select Phase) for a first-of-its-kind mobile modular ammonia demonstration unit designed to produce 5 metric tons per day (TPD). The unit was required to be fully containerized within two standard 40-foot ISO shipping containers and transportable across multiple European sites, operating approximately six months per location before relocation.
The client’s objective was not merely to design a small ammonia plant, but to validate a scalable, transportable deployment model while minimizing capital exposure and schedule risk. The solution had to rely on commercially available, off-the-shelf equipment wherever practical, comply with EU transportation and safety regulations, and maintain safe and maintainable operation within extreme spatial constraints.
GATE delivered a decision-grade FEL 2A package that included a validated 5 TPD technical configuration, a fully integrated 3D layout model, probabilistic capital cost distribution curves, and a long-lead procurement strategy. Through disciplined front-end loading and quantitative risk modeling, the project provided investors and stakeholders with clarity on technical feasibility, cost uncertainty, and next-phase decision readiness.
Challenges
The client sought to pioneer a transportable ammonia production unit capable of rapid deployment across European sites. Unlike conventional fixed ammonia facilities, this configuration required:
Full containment within two 40ft × 8ft × 8.5ft ISO containers
Repeated transportation via truck across EU road networks
Temporary site tie-ins and battery limits
Safe and reliable performance in diverse operating environments
The core challenge was to balance three competing demands:
Compactness within strict dimensional constraints
Use of commercially available equipment to limit custom fabrication
Capital discipline suitable for a demonstration-scale deployment
The client required a FEL 2A study that would confirm throughput feasibility, identify cost uncertainty, and de-risk advancement to FEL 3 without over-investing prematurely.
Specifications
The FEL 2A effort was structured to achieve five primary objectives:
Develop a technically credible 5 TPD configuration within a two-container footprint
Confirm throughput and process feasibility
Quantify capital cost uncertainty through probabilistic modeling
Identify long-lead equipment items that could impact schedule
Deliver a decision ready Select Phase report to support progression to FEL 3 (FEED Phase)
The mandate was clear: provide investment-grade clarity while preserving speed and capital efficiency.
Scope of Work Executed
To meet these objectives, GATE executed a structured scope aligned with disciplined front-end loading principles:
Identification of commercially available equipment suitable for integration
Equipment sizing validation within ISO container constraints
Development of a preliminary 3D model addressing layout, clearances, controls, accessibility, and maintainability
Transportation feasibility assessment across European road networks
Safety system definition, including pressure relief, fire protection, and emergency shutdown systems
Definition of battery limits and host-site tie-ins
Confirmation of design basis and throughput validation
Development of high-level PFDs and equipment layouts
Development of probabilistic CAPEX distribution curves
Identification of long-lead procurement items
Preparation of a consolidated FEL 2A Select Report
The resulting package established a technically and commercially grounded foundation for future phases.
Key Technical & Commercial Constraints
Several constraints required systematic resolution:
Aggressive Timeline
The client required rapid advancement through FEL 2A to maintain commercial momentum.
Iterative Modular Optimization
Modular design introduces inherent iteration as equipment sizing, layout, and operability constraints interact dynamically.
Severe Spatial Constraints
All equipment, piping, instrumentation, and safety systems had to fit within two standard containers while preserving access and maintainability.
Off-the-Shelf Equipment Requirement
The use of commercially available equipment limited customization flexibility but reduced procurement risk.
EU Transportation & Regulatory Compliance
Repeated transport required compliance with EU road regulations, lifting constraints, and operational safety standards.
Each constraint was addressed through structured technical trade-offs rather than reactive redesign.
GATE Energy’s Approach to Front-End Loading (FEL 2A – Select Phase)
GATE applied a disciplined FEL 2A framework designed to reduce uncertainty before major capital commitments.
The approach focused on:
Freezing a defensible Basis of Design (BoD)
Developing preliminary PFDs and equipment data sheets
Building an integrated 3D layout model to validate physical feasibility
Confirming battery limits and temporary utility requirements
Stress-testing design assumptions through structured reviews
Containerization was treated not as a packaging exercise, but as a systems engineering challenge. Equipment layout was optimized to maintain safe egress, access for maintenance, and operability within constrained envelopes. Hydraulic calculations and utility summaries validated performance assumptions early, preventing downstream rework.
The FEL 2A deliverables were designed to enable progression to FEL 3 without reopening foundational assumptions.
Risk Quantification & Decision Framework
A defining feature of this project was the quantitative treatment of risk.
GATE moved beyond qualitative heat maps and applied structured risk analytics:
Scope Maturity Risk – PDRI
The Project Definition Rating Index (PDRI) was used to quantify scope completeness and identify areas of residual definition risk.

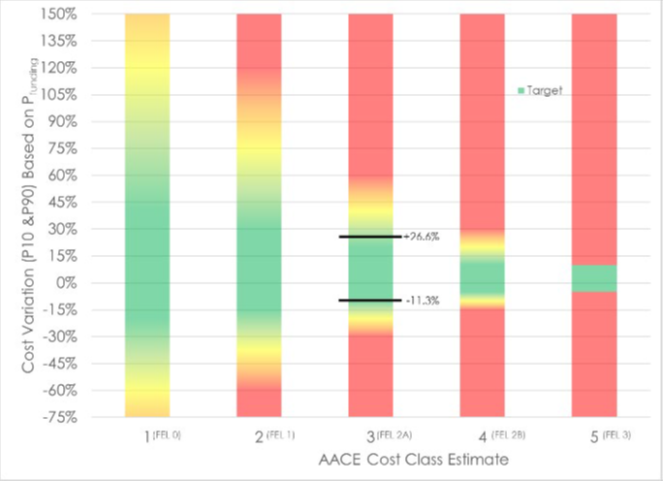

Systemic Risk – Parametric Modeling
Empirically validated parametric models were applied to quantify systemic cost drivers associated with modularization, small-scale process systems, and transportability.
Project-Specific Risk – Calibrated Experts
Calibrated subject matter experts quantified project-specific risks through structured elicitation methods.
Integrated Probabilistic CAPEX Modeling

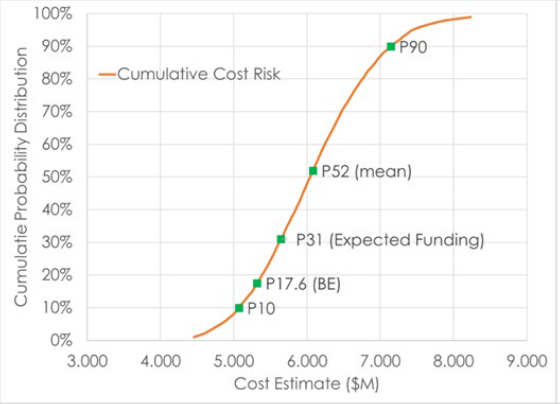

All risk dimensions were integrated into probabilistic capital cost distribution curves, providing a range of possible outcomes rather than a single deterministic estimate.
All risk dimensions were integrated into probabilistic capital cost distribution curves, providing a range of possible outcomes rather than a single deterministic estimate.
This framework provided decision-grade transparency on uncertainty ranges and confidence levels. The client was able to understand not only expected capital cost, but the probability distribution associated with that estimate.
Engineering & Delivery Execution Model
Execution leveraged a distributed engineering model.
A High Value Engineering Center (HVEC) in India supported detailed engineering tasks under tight schedule constraints while maintaining cost discipline. Structured technical reviews and governance ensured quality control and alignment with project objectives.
Despite the distributed model:
There were no quality deficiencies in deliverables
Schedule objectives were achieved
Coordination across time zones enhanced productivity
This demonstrated that global execution can reduce cost without degrading technical integrity when governed properly.
Technical Achievements & Benefits
The FEL 2A effort delivered:
A validated 5 TPD configuration within two ISO containers
A defensible Basis of Design

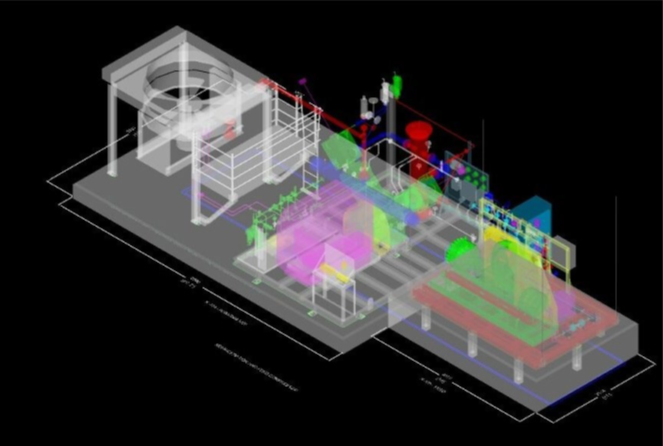

A preliminary 3D model confirming spatial feasibility
Defined battery limits and utility requirements
Identified long-lead equipment risks
Probabilistic CAPEX distribution curves supporting capital decision-making
A comprehensive Select Phase Report
The client exited FEL 2A with clarity on:
Technical feasibility
Capital exposure ranges
Schedule risk drivers
Procurement strategy
Importantly, the work exceeded client expectations and demonstrated the practical viability of the mobile ammonia concept.
Strategic Impact & Path Forward
This project illustrates how disciplined front-end loading and quantitative risk analytics can enable predictable project delivery in emerging energy technologies.
For modular energy systems—where scale, transportability, and replication are critical—uncertainty must be engineered out early. GATE’s approach demonstrated:
How containerization constraints can be systematically resolved
How probabilistic modeling strengthens investment confidence
How global execution models can compress cost and schedule
How FEL discipline reduces rework and downstream capital exposure
The 5 TPD mobile ammonia unit now stands as a scalable template for distributed ammonia deployment across multiple sites.
By integrating structured scope definition, quantitative risk modeling, and disciplined engineering governance, GATE Energy enabled a clear pathway from concept validation to execution readiness.
In emerging energy markets, predictability is a competitive advantage. This project demonstrates that with rigorous front-end loading and quantified risk intelligence, innovative technologies can move from aspiration to investable reality with confidence.
Energy projects are extraordinary. From a complex feasibility study to a full-scale, start-to-finish representative for your company, our Project Delivery team gets you through FID, construction, commissioning and initial startup without schedule and cost blowouts. Imagine a predictable project experience.
